Skip to content

Debugging Transition ToolsΒΆ

There are two flags that can help debugging t8n tools or the execution-testing framework:

  1. --evm-dump-dir: Write debug information from t8n tool calls to the specified directory.
  2. --traces: Collect traces of the execution from the transition tool.
  3. --verify-fixtures: Run go-ethereum's evm blocktest command to verify the generated test fixtures.

EVM Dump DirectoryΒΆ

The --evm-dump-dir flag tells the framework to write the inputs and outputs of every call made to the t8n command to the specified output directory. The aim is to help debugging or simply understand how a test is interacting with the EVM. When --traces is specified without an explicit --evm-dump-dir, a default directory of traces/ is used.

Each test case receives its own sub-directory under the --evm-dump-dir that contains these files which can be easily accessed from the HTML test report generated by fill (located by default in the root of the --output directory).

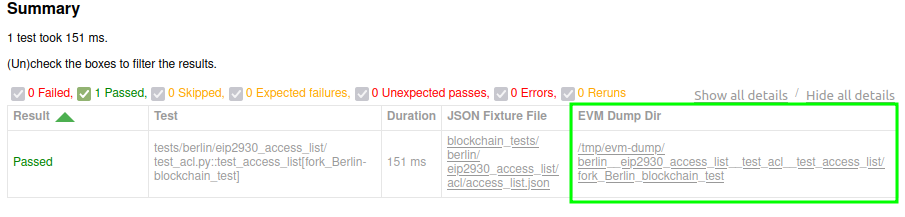

HTML Report Summary

In particular, a script t8n.sh is generated for each call to the t8n command which can be used to reproduce the call to trigger errors or attach a debugger without the need to execute Python.

For example, running:

fill tests/berlin/eip2930_access_list/ --fork Berlin -m blockchain_test \
    --evm-dump-dir=/tmp/evm-dump --traces

will produce the directory structure:

πŸ“‚ /tmp/evm-dump
└── πŸ“‚ berlin__eip2930_access_list__test_acl__test_access_list
    └── πŸ“‚ fork_Berlin_blockchain_test
        └── πŸ“‚ 0
            β”œβ”€β”€ πŸ“„ args.py
            β”œβ”€β”€ πŸ“‚ input
            β”‚   β”œβ”€β”€ πŸ“„ alloc.json
            β”‚   β”œβ”€β”€ πŸ“„ env.json
            β”‚   └── πŸ“„ txs.json
            β”œβ”€β”€ πŸ“‚ output
            β”‚   β”œβ”€β”€ πŸ“„ alloc.json
            β”‚   β”œβ”€β”€ πŸ“„ result.json
            β”‚   └── πŸ“„ txs.rlp
            β”œβ”€β”€ πŸ“„ returncode.txt
            β”œβ”€β”€ πŸ“„ stderr.txt
            β”œβ”€β”€ πŸ“„ stdin.txt
            β”œβ”€β”€ πŸ“„ stdout.txt
            β”œβ”€β”€ πŸ“„ t8n.sh
            └── πŸ“„ trace-0-0x5c4f07ce52f0a276a06aabdfff16cc693b5e007c018f9a42431e68200e2da515.jsonl

where the directory 0 is the starting index of the different calls made to the t8n tool executed during the test, and since the test only contains one block, there is only one directory present.

Note, there may be more directories present 1, 2, 3,... if the test executes more blocks.

Each directory contains files containing information corresponding to the call, for example, the args.py file contains the arguments passed to the t8n command and the output/alloc.json file contains the output of the t8n command's --output-alloc flag.

The t8n.sh ScriptΒΆ

The t8n.sh script written to the debug directory can be used to reproduce a specific call made to the t8n command during the test session. For example, if a Besu t8n-server has been started on port 3001, the request made by the test for first block can be reproduced as:

/tmp/besu/test_access_list_fork_Berlin/0/t8n.sh 3001

which writes the response the from the t8n-server to the console output:

{
  "alloc" : {
    "0x000000000000000000000000000000000000aaaa" : {
      "code" : "0x5854505854",
      "balance" : "0x4",
      "nonce" : "0x1"
    },
    "0x2adc25665018aa1fe0e6bc666dac8fc2697ff9ba" : {
      "balance" : "0x1bc16d674ecb26ce"
    },
    "0xa94f5374fce5edbc8e2a8697c15331677e6ebf0b" : {
      "balance" : "0x2cd931",
      "nonce" : "0x1"
    }
  },
  "body" : "0xf8a0b89e01f89b0180078304ef0094000000000000000000000000000000000000aaaa0180f838f7940000000000000000000000000000000000000000e1a0000000000000000000000000000000000000000000000000000000000000000001a02e16eb72206c93c471b5894800495ee9c64ae2d9823bcc4d6adeb5d9d9af0dd4a03be6691e933a0816c59d059a556c27c6753e6ce76d1e357b9201865c80b28df3",
  "result" : {
    "stateRoot" : "0x51799508f764047aee6606bc6a00863856f83ee5b91555f00c8a3cbdfbec5acb",
    ...
    ...
  }
}

The t8n.sh is written to the debug directory for all supported t8n tools.

Verifying Test Fixtures via evm blocktestΒΆ

The --verify-fixtures flag can be used to run go-ethereum's evm blocktest command in order to verify the generated JSON test fixtures.

For example, running:

fill tests/berlin/eip2930_access_list/ --fork Berlin -m blockchain_test \
    --evm-dump-dir==/tmp/evm-dump \
    --evm-bin=../evmone/build/bin/evmone-t8n \
    --verify-fixtures-bin=../go-ethereum/build/bin/evm \
    --verify-fixtures

will additionally run the evm blocktest command on every JSON fixture file and write its output to the EVM dump directory:

πŸ“‚ /tmp/evm-dump
└── πŸ“‚ berlin__eip2930_access_list__test_acl__test_access_list
    β”œβ”€β”€ πŸ“„ fixtures.json
    β”œβ”€β”€ πŸ“‚ fork_Berlin_blockchain_test
    β”‚   β”œβ”€β”€ πŸ“‚ 0
    β”‚   β”‚   β”œβ”€β”€ πŸ“„ args.py
    β”‚   β”‚   β”œβ”€β”€ πŸ“‚ input
    β”‚   β”‚   β”‚   β”œβ”€β”€ πŸ“„ alloc.json
    β”‚   β”‚   β”‚   β”œβ”€β”€ πŸ“„ env.json
    β”‚   β”‚   β”‚   └── πŸ“„ txs.json
    β”‚   β”‚   β”œβ”€β”€ πŸ“‚ output
    β”‚   β”‚   β”‚   β”œβ”€β”€ πŸ“„ alloc.json
    β”‚   ... ... ...
    β”‚
    β”œβ”€β”€ πŸ“„ verify_fixtures_args.py
    β”œβ”€β”€ πŸ“„ verify_fixtures_returncode.txt
    β”œβ”€β”€ πŸ“„ verify_fixtures.sh
    β”œβ”€β”€ πŸ“„ verify_fixtures_stderr.txt
    └── πŸ“„ verify_fixtures_stdout.txt

where the verify_fixtures.sh script can be used to reproduce the evm blocktest command.

Further --verify-fixtures ExamplesΒΆ

  1. No fixture verification performed:

    fill

  2. Verify fixtures: Use the first evm binary in the PATH to execute both the t8n and blocktest commands (i.e., same binary used; this must be a geth binary):

    fill --verify-fixtures

  3. Explicitly specify the evm binary to execute the blocktest command (the first evm binary in the PATH is used for t8n commands; --verify-fixtures is not necessary):

    fill --verify-fixtures-bin=../go-ethereum/build/bin/evm

  4. Explicitly set two different evm binaries to execute the t8n and blocktest commands; write debug data to the specified --evm-dump-dir:

    fill --evm-bin=../evmone/build/bin/evmone-t8n \
      --verify-fixtures-bin=../go-ethereum/build/bin/evm \
      --evm-dump-dir=/tmp/evm-dump

  5. Additionally use --single-fixture-per-file to improve the granularity of the reporting of the evm blocktest command by writing the fixture generated by each parametrized test case to its own file.

    fill --evm-bin=../evmone/build/bin/evmone-t8n \
      --verify-fixtures-bin=../go-ethereum/build/bin/evm \
      --evm-dump-dir=/tmp/evm-dump \
      --single-fixture-per-file


Execution scope of evm blocktest

Note, by default, that evm blocktest is not executed per parametrized test case, but rather per test function. This is because each fixture JSON file contains fixtures for all the parametrized test cases for one test function. This means only one error will be reported, even if multiple fixtures fail within one fixture file.

Additionally, it is only executed after all the test cases in the module have been executed1 and will only report the first failing test fixture in all files, even if there are multiple failing fixture files.

This means, by default, that the feedback is not as granular as for test case execution. To improve granularity, and get feedback per parametrized test case use --single-fixture-per-file.


  1. This limitation is required to enable support of the pytest-xdist plugin for concurrent test execution across multiple CPUs. To achieve this we use the we apply the --dist loadscope xdist flag in our pytest-fill.ini↩
