Debugging Transition ToolsΒΆ
There are two flags that can help debugging t8n tools or the execution-testing framework:
--evm-dump-dir: Write debug information fromt8ntool calls to the specified directory.--traces: Collect traces of the execution from the transition tool.--verify-fixtures: Run go-ethereum'sevm blocktestcommand to verify the generated test fixtures.
EVM Dump DirectoryΒΆ
The --evm-dump-dir flag tells the framework to write the inputs and outputs of every call made to the t8n command to the specified output directory. The aim is to help debugging or simply understand how a test is interacting with the EVM.
When --traces is specified without an explicit --evm-dump-dir, a default directory of traces/ is used.

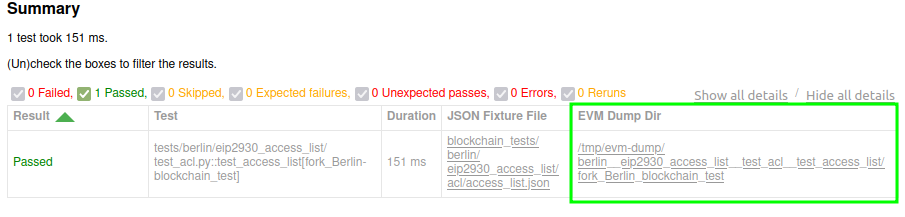

Each test case receives its own sub-directory under the --evm-dump-dir that contains these files which can be easily accessed from the HTML test report generated by fill (located by default in the root of the --output directory).
In particular, a script t8n.sh is generated for each call to the t8n command which can be used to reproduce the call to trigger errors or attach a debugger without the need to execute Python.
For example, running:
fill tests/berlin/eip2930_access_list/ --fork Berlin -m blockchain_test \
--evm-dump-dir=/tmp/evm-dump --traces
will produce the directory structure:
π /tmp/evm-dump
βββ π berlin__eip2930_access_list__test_acl__test_access_list
βββ π fork_Berlin_blockchain_test
βββ π 0
βββ π args.py
βββ π input
β βββ π alloc.json
β βββ π env.json
β βββ π txs.json
βββ π output
β βββ π alloc.json
β βββ π result.json
β βββ π txs.rlp
βββ π returncode.txt
βββ π stderr.txt
βββ π stdin.txt
βββ π stdout.txt
βββ π t8n.sh
βββ π trace-0-0x5c4f07ce52f0a276a06aabdfff16cc693b5e007c018f9a42431e68200e2da515.jsonl
where the directory 0 is the starting index of the different calls made to the t8n tool executed during the test, and since the test only contains one block, there is only one directory present.
Note, there may be more directories present 1, 2, 3,... if the test executes more blocks.
Each directory contains files containing information corresponding to the call, for example, the args.py file contains the arguments passed to the t8n command and the output/alloc.json file contains the output of the t8n command's --output-alloc flag.
The t8n.sh ScriptΒΆ
The t8n.sh script written to the debug directory can be used to reproduce a specific call made to the t8n command during the test session. For example, if a Besu t8n-server has been started on port 3001, the request made by the test for first block can be reproduced as:
/tmp/besu/test_access_list_fork_Berlin/0/t8n.sh 3001
which writes the response the from the t8n-server to the console output:
{
"alloc" : {
"0x000000000000000000000000000000000000aaaa" : {
"code" : "0x5854505854",
"balance" : "0x4",
"nonce" : "0x1"
},
"0x2adc25665018aa1fe0e6bc666dac8fc2697ff9ba" : {
"balance" : "0x1bc16d674ecb26ce"
},
"0xa94f5374fce5edbc8e2a8697c15331677e6ebf0b" : {
"balance" : "0x2cd931",
"nonce" : "0x1"
}
},
"body" : "0xf8a0b89e01f89b0180078304ef0094000000000000000000000000000000000000aaaa0180f838f7940000000000000000000000000000000000000000e1a0000000000000000000000000000000000000000000000000000000000000000001a02e16eb72206c93c471b5894800495ee9c64ae2d9823bcc4d6adeb5d9d9af0dd4a03be6691e933a0816c59d059a556c27c6753e6ce76d1e357b9201865c80b28df3",
"result" : {
"stateRoot" : "0x51799508f764047aee6606bc6a00863856f83ee5b91555f00c8a3cbdfbec5acb",
...
...
}
}
The t8n.sh is written to the debug directory for all supported t8n tools.
Printed TracesΒΆ
If a test fails while filling with --traces, the traces of each transaction are also printed as a table, one row per execution step. Use -s so that pytest does not capture the output:
fill tests/frontier/opcodes/test_dup.py --fork Frontier --traces -s
Step PC Op Gas Cost Depth Stack
βββββββββββββββββββββββββββββββββββββββββββββββββββββββββββββββββββ
0 0 PUSH1 119979000 3 1
1 2 PUSH1 119978997 3 1 0x0
2 4 PUSH1 119978994 3 1 0x1 0x0
...
17 34 DUP10 119978949 3 1 0x10 0xf 0xe 0xd ...
18 35 PUSH1 119978946 3 1 0x7 0x10 0xf 0xe ...
19 37 SSTORE 119978943 20000 1 0x0 0x7 0x10 0xf ...
The stack column shows the top four values, topmost first, and op names are indented by call depth. An error column is added when a step has an error. Only the last 1000 steps of each transaction are printed, since errors usually show up at the end; the full traces are still written to the .jsonl files in the EVM dump directory.
Verifying Test Fixtures via evm blocktestΒΆ
The --verify-fixtures flag can be used to run go-ethereum's evm blocktest command in order to verify the generated JSON test fixtures.
For example, running:
fill tests/berlin/eip2930_access_list/ --fork Berlin -m blockchain_test \
--evm-dump-dir==/tmp/evm-dump \
--evm-bin=../evmone/build/bin/evmone \
--verify-fixtures-bin=../go-ethereum/build/bin/evm \
--verify-fixtures
will additionally run the evm blocktest command on every JSON fixture file and write its output to the EVM dump directory:
π /tmp/evm-dump
βββ π berlin__eip2930_access_list__test_acl__test_access_list
βββ π fixtures.json
βββ π fork_Berlin_blockchain_test
β βββ π 0
β β βββ π args.py
β β βββ π input
β β β βββ π alloc.json
β β β βββ π env.json
β β β βββ π txs.json
β β βββ π output
β β β βββ π alloc.json
β ... ... ...
β
βββ π verify_fixtures_args.py
βββ π verify_fixtures_returncode.txt
βββ π verify_fixtures.sh
βββ π verify_fixtures_stderr.txt
βββ π verify_fixtures_stdout.txt
where the verify_fixtures.sh script can be used to reproduce the evm blocktest command.
Further --verify-fixtures ExamplesΒΆ
-
No fixture verification performed:
fill -
Verify fixtures: Use the first
evmbinary in thePATHto execute both thet8nandblocktestcommands (i.e., same binary used; this must be a geth binary):fill --verify-fixtures -
Explicitly specify the evm binary to execute the
blocktestcommand (the first evm binary in thePATHis used fort8ncommands;--verify-fixturesis not necessary):fill --verify-fixtures-bin=../go-ethereum/build/bin/evm -
Explicitly set two different
evmbinaries to execute thet8nandblocktestcommands; write debug data to the specified--evm-dump-dir:fill --evm-bin=../evmone/build/bin/evmone \ --verify-fixtures-bin=../go-ethereum/build/bin/evm \ --evm-dump-dir=/tmp/evm-dump -
Additionally use
--single-fixture-per-fileto improve the granularity of the reporting of theevm blocktestcommand by writing the fixture generated by each parametrized test case to its own file.fill --evm-bin=../evmone/build/bin/evmone \ --verify-fixtures-bin=../go-ethereum/build/bin/evm \ --evm-dump-dir=/tmp/evm-dump \ --single-fixture-per-file
Execution scope of evm blocktest
Note, by default, that evm blocktest is not executed per parametrized test case, but rather per test function. This is because each fixture JSON file contains fixtures for all the parametrized test cases for one test function. This means only one error will be reported, even if multiple fixtures fail within one fixture file.
Additionally, it is only executed after all the test cases in the module have been executed1 and will only report the first failing test fixture in all files, even if there are multiple failing fixture files.
This means, by default, that the feedback is not as granular as for test case execution. To improve granularity, and get feedback per parametrized test case use --single-fixture-per-file.
-
This limitation is required to enable support of the
pytest-xdistplugin for concurrent test execution across multiple CPUs. To achieve this we use the we apply the--dist loadscopexdist flag in ourpytest-fill.ini. β©
